Last updated: July 19, 2026

10x10 Concrete Slab Cost: Full Breakdown & Estimate

10x10 concrete slab cost comparison chart showing price ranges for patio, shed pad, and foundation

A 10x10 concrete slab costs $600 to $1,200 for a standard 4-inch residential pour in 2026, with most homeowners paying near $800 for a basic broom-finished patio or shed pad. Add reinforcement, thicker pours, or decorative finishes and the range extends to $1,500-$2,500.

The 10x10 slab is one of the most searched concrete projects online — and for good reason. It is the perfect size for a small patio, a shed foundation, a grill pad, or a hot tub base. But quotes vary dramatically depending on thickness, finish, reinforcement, and whether you pour it yourself or hire a contractor.

This guide cuts through the guesswork. We have analyzed 2026 pricing data from HomeAdvisor, Angi, the National Ready Mixed Concrete Association, and contractor estimates across all US regions to give you exact numbers you can budget with.

Who should use this guide: Homeowners planning a 10x10 concrete project, DIYers estimating material costs, contractors quoting small residential slabs, and anyone using the Concrete Slab Cost Calculator who wants to understand the numbers behind the results.

Looking for a larger size? See our 20x20 concrete slab cost guide for a complete breakdown of the most popular residential slab dimension.

Quick Answer: 10x10 Concrete Slab Cost (2026)

Project TypeThicknessReinforcementFinishCost Range
Basic Patio / Walkway4 inchesWire meshBroom$600 - $1,000
Shed Foundation4 inchesWire meshBroom$700 - $1,100
Reinforced Patio4 inchesRebar (#3)Broom$800 - $1,200
Heavy Shed / Equipment6 inchesRebar (#3)Broom$1,000 - $1,500
Foundation Pad6 inchesRebar + meshBroom$1,200 - $1,800
Stamped Decorative Patio4 inchesWire meshStamped$1,500 - $2,500
Colored / Stained Patio4 inchesWire meshIntegral color$1,200 - $2,000
💡
These are national averages for professional installation. DIY material costs run 40-50% lower. Your actual price depends on location, site conditions, and contractor availability. Use our Concrete Slab Calculator for a custom estimate based on your exact dimensions and specs.

10x10 Slab Cost by Thickness

Thickness is the single biggest cost driver. A slab is priced by volume, and volume scales straight with thickness. Going from 4 inches to 5 inches is not a rounding error — it is 25% more concrete.

ThicknessCubic YardsConcrete OnlyInstalled CostBest For
3 inches0.93$140 - $160$500 - $800NOT recommended — prone to cracking
4 inches1.23$185 - $215$600 - $1,000Patios, walkways, shed pads (standard)
5 inches1.54$230 - $270$800 - $1,200Light-use driveways, porches
6 inches1.85$275 - $325$1,000 - $1,500Driveways, garage floors, foundations
8 inches2.47$370 - $430$1,300 - $1,900Heavy equipment, commercial use

What the data says: A standard 4-inch slab is sufficient for most residential 10x10 projects. Each additional inch adds roughly $1-$2 per square foot. For a 10x10 slab, going from 4 inches to 6 inches adds about $400-$500 to your total. Only go thicker if you are parking vehicles or installing heavy structures. A 3-inch slab is not recommended for any permanent installation — it will crack under normal loads.

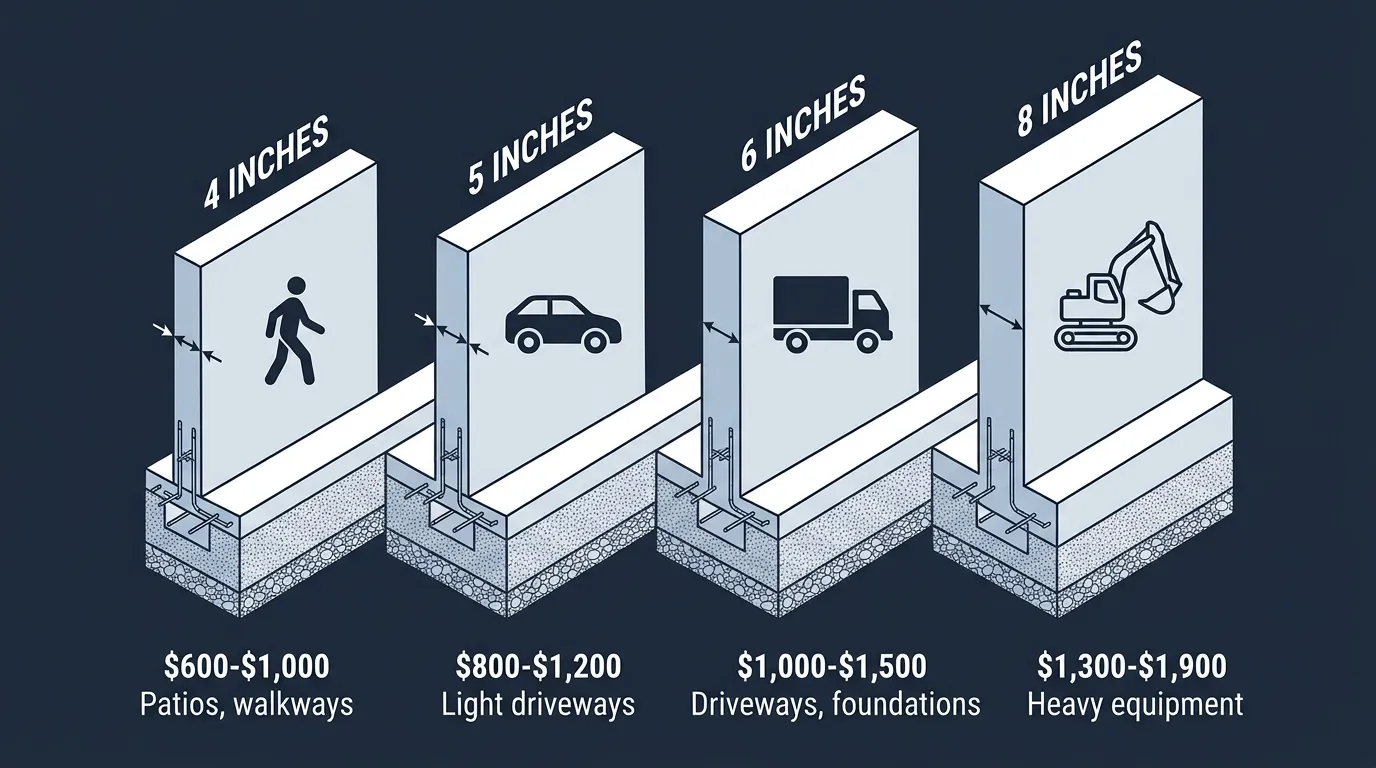

Cross-section diagram showing 10x10 slab at 4, 5, 6, and 8 inch thicknesses with load capacity icons and cost per thickness

10x10 Slab Cost by Finish Type

The surface finish affects both cost and appearance. Here is what each option costs for a 10x10 slab.

Finish TypeAdded CostTotal 10x10 CostLook & Durability
Broom finish$0 (standard)$600 - $1,000Textured, slip-resistant, hides imperfections
Smooth trowel$50 - $100$650 - $1,100Clean, modern, can be slippery when wet
Exposed aggregate$200 - $400$800 - $1,400Decorative stone visible, excellent traction
Stamped concrete$500 - $1,200$1,100 - $2,200Brick, stone, or wood patterns, high-end look
Colored (integral)$300 - $700$900 - $1,700Uniform color throughout, fade-resistant
Acid stained$200 - $500$800 - $1,500Varied, artistic color effects, unique patterns
Polished$800 - $1,500$1,400 - $2,500Mirror-like finish, indoor use primarily

What the data says: Broom finish is the default for most residential slabs and adds no extra cost. Stamped and colored finishes can double your price but transform the look of your outdoor space. For a 10x10 patio that is part of your outdoor living area, a stamped or colored finish may be worth the investment. Polished concrete is typically used indoors and is overkill for most exterior 10x10 projects.

10x10 Slab Cost by Reinforcement

Concrete is strong under compression but weak under tension. Reinforcement prevents cracking and is essential for anything beyond a basic walkway.

Reinforcement TypeCost for 10x10Strength AddedBest ForWhen to Skip
None$0NoneTemporary pads onlyNOT recommended for permanent work
Wire mesh (6x6, 10/10)$40 - $100ModeratePatios, walkways, shed padsIf parking vehicles or heavy loads
Rebar (#3, 18" grid)$140 - $185HighDriveways, garage floors, foundationsBasic foot-traffic-only patios
Fiber mesh (in mix)$15 - $25Low-ModerateCrack-resistant floors, added insuranceAs standalone on thick slabs
Rebar + wire mesh$180 - $285MaximumHeavy equipment, maximum durabilityStandard residential projects

What the data says: Wire mesh is the sweet spot for most 10x10 projects. It adds only $40-$100 to your total but significantly reduces cracking. Rebar is overkill for a basic patio but necessary if you are parking a vehicle or installing a hot tub. Fiber mesh is a cost-effective add-on ($15-$25 total) that improves crack resistance without the labor of installing mesh — but it should not replace physical reinforcement on load-bearing slabs.

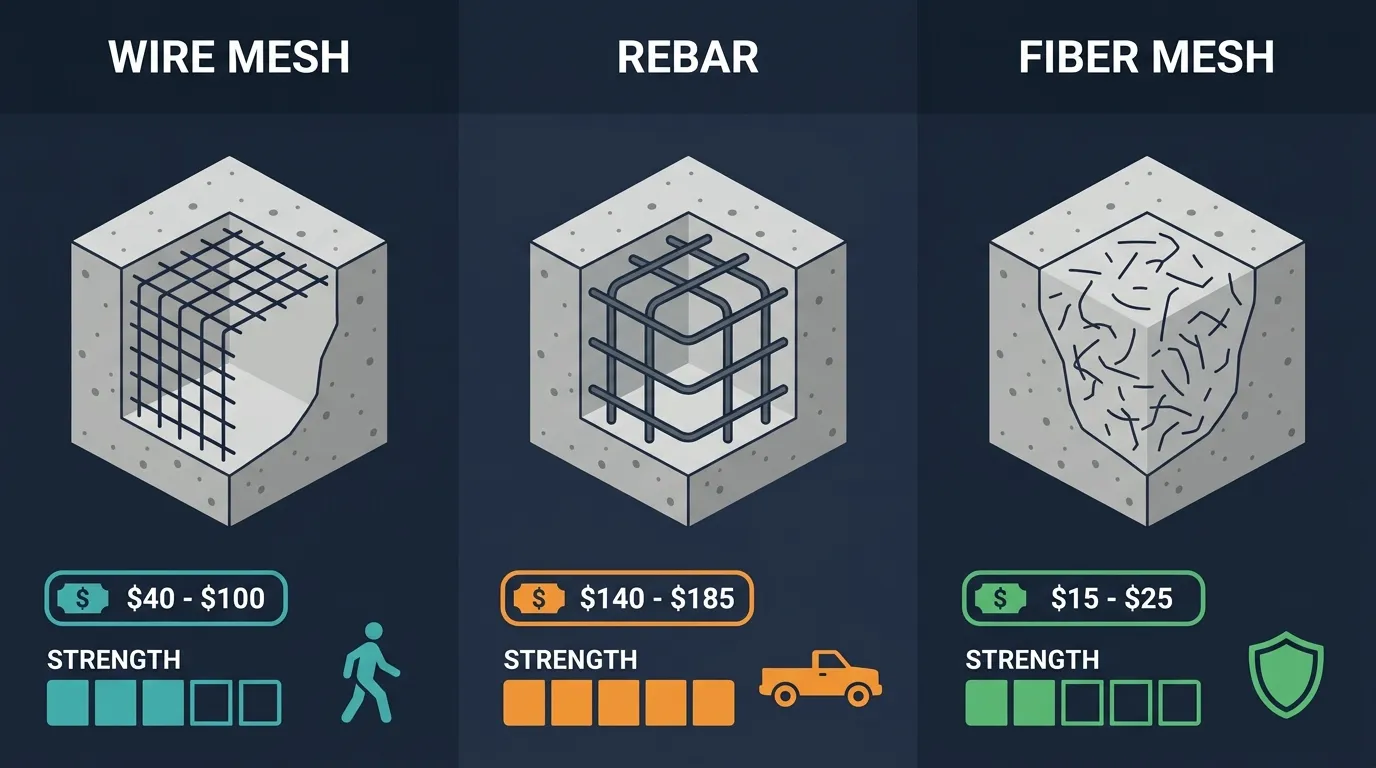

Infographic showing three reinforcement options side by side: wire mesh grid, rebar grid, and fiber mesh in concrete mix

DIY vs Professional Installation: 10x10 Slab

The biggest cost variable is who does the work. Here is the honest breakdown for a 10x10, 4-inch slab.

DIY Material Costs (10x10, 4-inch, broom finish)

ItemQuantityUnit CostTotal
Concrete (3,000 PSI, 1.23 yd³)56 bags (80lb)$5.50/bag$308
OR ready-mix delivery1.23 cubic yards$185/yd$228
Wire mesh (6x6)100 sq ft$0.60/sq ft$60
Gravel sub-base (4")1.5 cubic yards$35/yd$53
2x4 forms + stakes40 linear ft$2.00/ft$80
Concrete finishing toolsRental$75/day$75
Sealer (optional, 1 gal)1 gallon$45$45
TOTAL DIY (bagged)$621
TOTAL DIY (ready-mix)$541
💡
Bagged vs ready-mix: For a 10x10 slab, bagged concrete often costs more per cubic yard than ready-mix delivery once you factor in the short-load fee. However, bagged concrete gives you time flexibility — you can mix and pour at your own pace. Ready-mix must be poured within 90 minutes of batching. For a 10x10 slab, 56 bags is manageable with 2-3 people and a mixer.

Professional Installation Costs (10x10, 4-inch, broom finish)

Cost ComponentLowHighNotes
Concrete material$185$2301.23 cubic yards at $150-$185/yd
Short-load fee$50$110Charged for orders under 3-4 yards
Delivery fee$0$75Varies by distance from plant
Wire mesh$40$1006x6 welded wire fabric
Site prep (grading)$0$200Flat site vs. sloped/uneven
Labor (pour + finish)$250$5002-3 workers, 3-4 hours
TOTAL PROFESSIONAL$600$1,200

What the data says: Pouring a 10x10 slab yourself saves $200-$600 in labor. But concrete work is unforgiving — mistakes in mixing, leveling, or finishing are expensive to fix. A 10x10 slab is small enough to handle DIY if you have experience, but hiring a pro ensures code compliance, proper curing, and a warranty. For your first concrete project, consider hiring a contractor and learning from the process before attempting DIY.

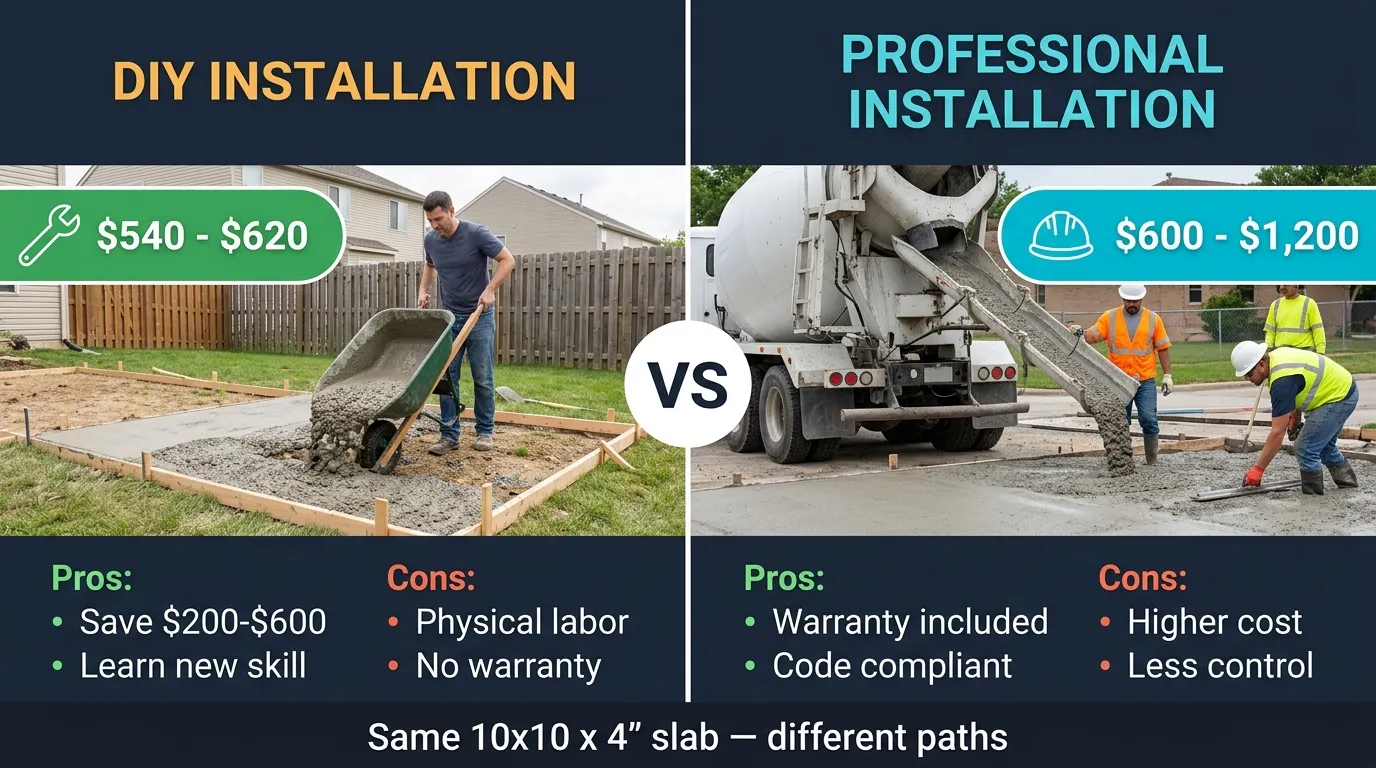

DIY vs professional concrete slab installation cost comparison for 10x10 slab

Cost Breakdown by Component: 10x10 Slab

Here is exactly where every dollar goes in a professionally installed 10x10 concrete slab.

ComponentLowHigh% of TotalWhat You Get
Ready-mix concrete$185$23025-30%1.23 cubic yards, 3,000 PSI
Short-load fee$50$1105-12%Surcharge for small orders
Delivery$0$750-8%Distance-based, sometimes free
Reinforcement$40$1855-15%Wire mesh or rebar
Site preparation$0$2000-15%Grading, excavation, gravel base
Labor$250$50025-50%Forming, pouring, finishing, cleanup
Finishing upgrade$0$1,2000-50%Stamped, colored, exposed aggregate
Sealer$40$1003-8%Protective coating, 2-3 year lifespan
TOTAL$600$1,800100%

What the data says: For a basic 10x10 patio, concrete material and delivery make up about 30-40% of the cost, labor is 25-50%, and everything else is 10-30%. For a decorative stamped slab, finishing can jump to 40-50% of the total. The short-load fee is a hidden cost many homeowners miss — it adds $50-$110 simply because a 10x10 slab does not fill a full truck.

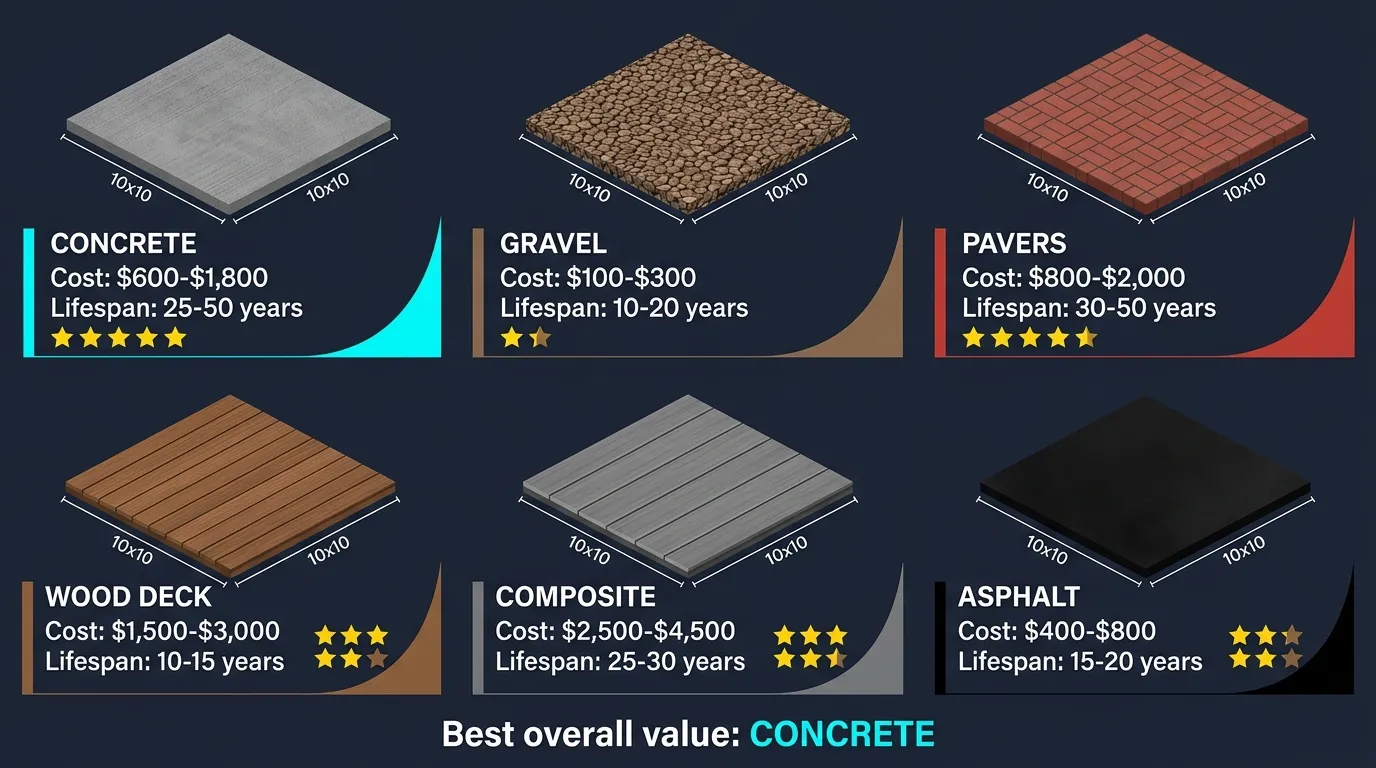

10x10 concrete slab materials cost breakdown comparison chart

Hidden Costs Most Homeowners Miss

Based on contractor data and homeowner reports, here are the costs that catch people off guard on a 10x10 slab project:

Hidden CostTypical RangeWhen It AppliesHow to Avoid
Short-load fee$50 - $110Ordering under 3-4 cubic yardsCoordinate with neighbor to share truck
Concrete pump$400 - $800/dayTruck cannot reach pour siteEnsure truck access within 20 feet
Weekend delivery$50 - $100Saturday/Sunday poursSchedule for weekday
Fuel surchargeVariableDiesel price spikesAsk for all-inclusive quote
Old slab removal$200 - $600Replacing existing concreteDIY demolition to save $300-$400
Permits$50 - $500Some municipalities requireCheck local codes before starting
Excavation/grading$100 - $500Sloped or uneven groundDIY site prep if possible
Expansion joints$0 - $50Slabs over 10 feet in directionIncluded in most contractor bids
Anchor bolts$5 - $20 eachAttaching shed or structureBuy yourself, install during pour
Wait time$75 - $150/hrDelay between delivery and pourHave crew ready before truck arrives
Cold weather protection$100 - $300Pouring below 40°FUse heated blankets or wait for spring
⚠️
Budget tip: Always add 10-15% contingency to your total. For a $1,000 slab, budget $1,100-$1,150 to cover surprises. The short-load fee alone can add 10% to a small 10x10 project.

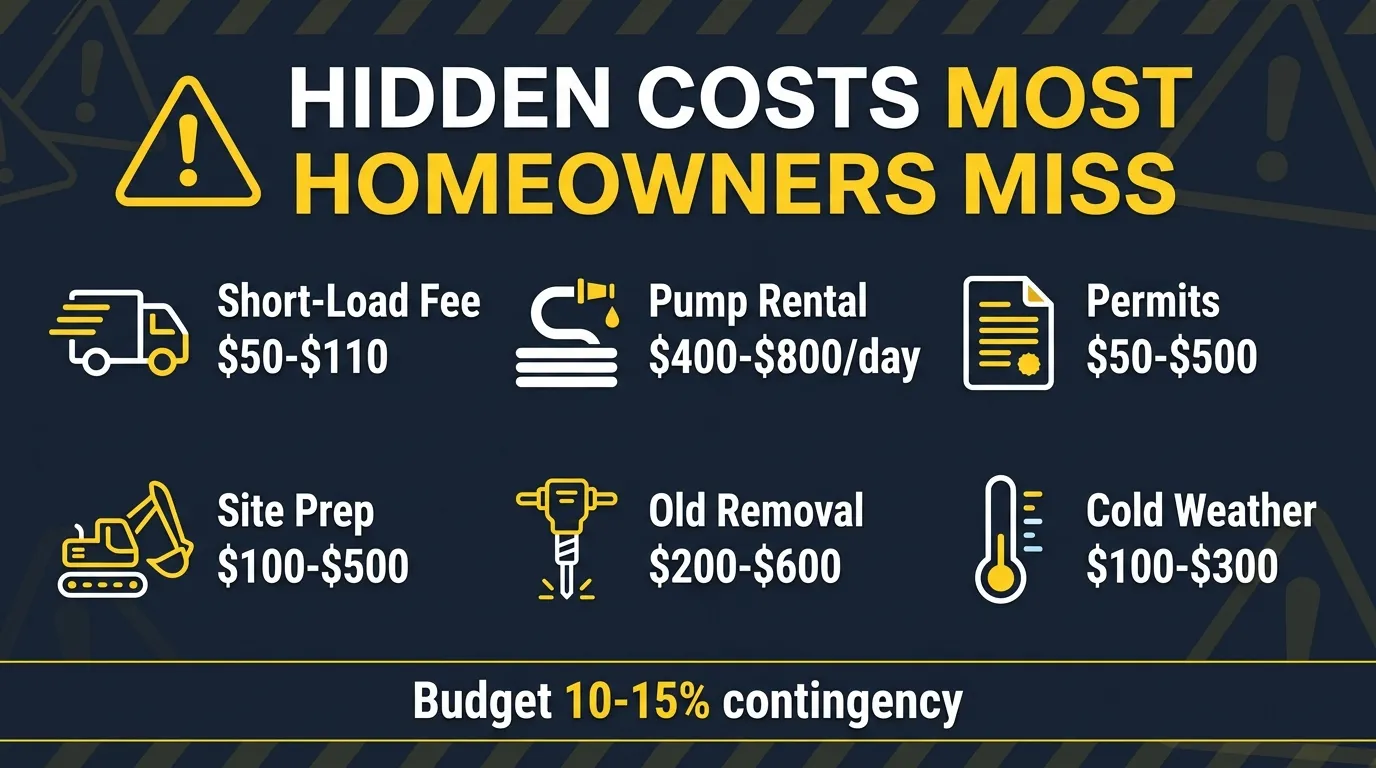

Infographic showing hidden costs of 10x10 concrete slab projects

10x10 Slab Cost by Region (2026)

Where you build matters as much as what you build. Labor rates, material availability, and delivery logistics all affect your final price.

RegionCost Range (4-inch, installed)Cost per Sq FtKey Factors
Southeast$500 - $900$5 - $9Lowest labor rates, abundant materials, no frost concerns
Midwest$600 - $1,000$6 - $10Moderate labor, wide availability, freeze-thaw cycles
Southwest$650 - $1,100$6.50 - $11Higher transport costs, extreme heat considerations
Northeast$800 - $1,400$8 - $14Highest labor rates, strict permits, shorter season
West Coast$700 - $1,200$7 - $12Highest material costs, seismic requirements, labor shortages
Rural / Remote+$100 - $300+$1 - $3Extra delivery distance, limited suppliers

What the data says: A 10x10 slab in the Southeast costs roughly 30-40% less than the same slab in the Northeast. Metro areas consistently cost more than rural locations due to higher labor rates and delivery logistics. The West Coast has the highest material costs ($150-$200/yd³) while the Southeast has the lowest ($120-$150/yd³). Always get local quotes — national averages can be off by 30% or more for your specific market.

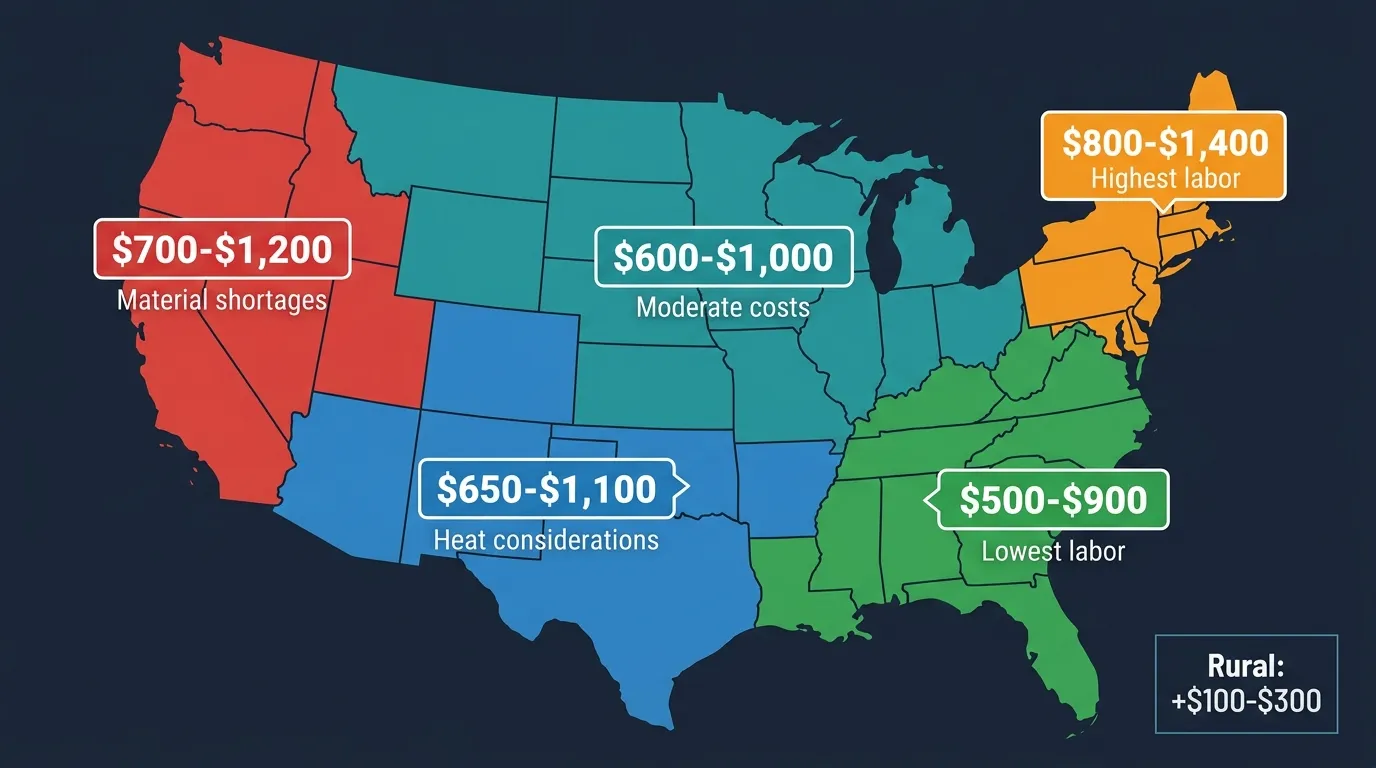

10x10 concrete slab cost by US region map showing Southeast, Midwest, Southwest, Northeast, and West Coast prices

How to Calculate Your Own 10x10 Slab Cost

If you want a quick estimate, here is the exact math:

1
Calculate Concrete Volume

Volume (cubic yards) = (Length x Width x Thickness in feet) / 27. For a 10x10 slab at 4 inches: Thickness in feet = 4 / 12 = 0.333. Volume = (10 x 10 x 0.333) / 27 = 1.23 cubic yards.

2
Calculate Material Cost

Material Cost = Cubic Yards x Price per Yard. At $160/yard: 1.23 x $160 = $197.

3
Estimate Total Installed Cost

Total Cost = Square Footage x Installed Cost per sq ft. For a 10x10 slab at $8/sq ft: 100 x $8 = $800.

4
Calculate Bag Count (if DIY)

Bag count = (Volume in cubic feet) / (Bag yield). 1.23 cubic yards = 33.2 cubic feet. 80lb bags (0.60 cu ft each): 33.2 / 0.60 = 55.3 bags. Always add 10% extra for waste.

⚠️
Always add 10% extra for waste, spills, and uneven ground. For a 10x10 slab, order 62 bags of 80lb mix or 82 bags of 60lb mix.

Use Our Free 10x10 Concrete Calculator

Our Concrete Slab Cost Calculator does all the math for you. Enter length, width, thickness, choose your finish type, and adjust concrete price per yard — get an instant, accurate estimate with cubic yards, bag count, and total cost. No signup required.

Concrete Slab Cost Calculator

10x10 Slab Project Timeline

A typical 10x10 residential slab follows this timeline. Most projects take 2-5 days from site prep to walkable surface.

1
Day 1: Site Prep & Forms (4-8 hours)

Excavate to required depth (typically 6-8 inches to allow for 4-inch gravel base + 4-inch concrete). Level the area, compact the subgrade with a plate compactor, and install wooden forms. Set reinforcement (wire mesh or rebar) on chairs so it sits in the middle of the slab thickness.

2
Day 2: Pour & Finish (3-4 hours)

Concrete truck arrives (or begin mixing bags). Pour into forms, spread with a rake, screed to level with a straight 2x4, bull float to smooth, and apply finish (broom, smooth, or stamp). Edge the perimeter and cut control joints every 5-6 feet to prevent random cracking.

3
Day 3-7: Curing

Keep the slab moist for 7 days. Cover with plastic sheeting or apply curing compound. Walkable after 24-48 hours. Light use after 7 days. Full strength at 28 days. Do not seal until after 28 days.

⚠️
Weather matters: Avoid pouring in extreme heat (above 90°F) or cold (below 40°F). Ideal conditions are 50-80°F with low wind. Rain during finishing can ruin the surface. In hot weather, pour early morning and mist the slab to prevent rapid drying. In cold weather, use heated blankets or calcium chloride accelerator.

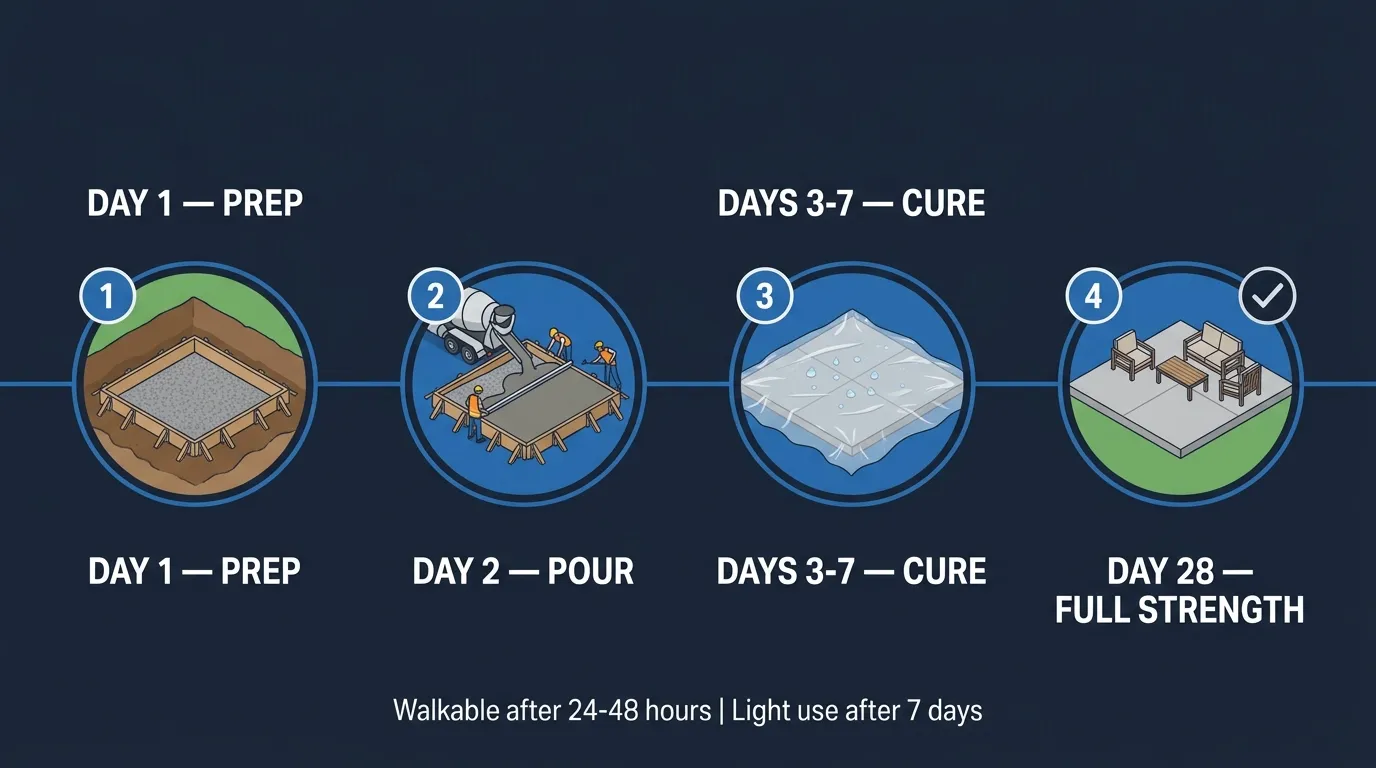

10x10 concrete slab project timeline showing site prep, pour, and curing stages

Is a 10x10 Concrete Slab Worth the Cost?

For most homeowners, yes. Here is why a 10x10 concrete slab is a smart investment:

BenefitDetailsValue
DurabilityLasts 25-50+ years with minimal maintenance$0.27-$0.50 per sq ft per year
Low maintenanceOccasional sealing every 2-3 years. No annual repairs.$40-$100 every 2-3 years
Resale valueAdds functional outdoor living space50-80% cost recovery at resale
VersatilityPatio, shed pad, grill station, hot tub base, outdoor kitchenOne slab, multiple uses
StrengthSupports 3,000+ PSI after 28 daysHandles vehicles, structures, heavy loads
Pest resistantUnlike wood decks, concrete does not rot or attract termitesNo chemical treatments needed

What the data says: At $800 installed lasting 30 years, a 10x10 concrete slab costs approximately $27 per year — cheaper than a wood deck ($100-$150/year with maintenance) or pavers ($50-$75/year with joint sand replacement). The initial investment pays off in durability and low ongoing costs.

Cost Saving Tips for Your 10x10 Slab

You do not have to overpay for a quality slab. Here are proven ways to reduce costs without cutting corners:

  • Prepare the site yourself. Excavation, grading, and gravel base installation are labor-intensive but do not require skilled trade work. DIY this step and save $100-$500.
  • Choose broom finish. A basic broom finish costs $0 extra. Stamped or colored finishes can add $500-$1,500 to a 10x10 slab. If budget is tight, upgrade later with concrete stain or paint.
  • Skip rebar for light use. Wire mesh is sufficient for patios and shed pads. Only use rebar if you are parking vehicles or installing heavy equipment. This saves $100-$140.
  • Avoid short-load fees. A 10x10 slab at 4 inches needs only 1.23 cubic yards — well under the 3-4 yard minimum for most plants. Coordinate with a neighbor to share a truck, or schedule multiple small pours together. This saves $50-$110.
  • Pour in the off-season. Contractors are less busy in late fall and early spring. Some offer 5-15% discounts during slow periods to keep crews working.
  • Get 3 itemized quotes. Prices vary 30-50% between contractors. Get detailed written quotes with the same specs for fair comparison.
  • DIY the finishing. If you are confident, pour the concrete yourself and hire a finisher for the final trowel work. This hybrid approach saves $150-$300.
  • Buy anchor bolts yourself. If attaching a shed, buy anchor bolts at a hardware store ($5-$20) instead of paying contractor markup.
  • Use fiber mesh as add-on. At $15-$25 total, fiber mesh improves crack resistance without the labor cost of installing wire mesh.

10x10 Slab vs Alternatives

Not sure if concrete is right for your 10x10 project? Here is how it compares to common alternatives.

MaterialCost (10x10)LifespanAnnual MaintenanceBest ForWorst For
Concrete slab$600 - $1,80025-50 years$15 - $30Permanent structures, patios, foundationsVery tight budgets
Gravel pad$100 - $30010-20 years$50 - $100Temporary sheds, budget projectsPermanent structures, wet climates
Pavers$800 - $2,00030-50 years$30 - $60Decorative patios, easy repairHeavy loads, settling issues
Wood deck$1,500 - $3,00010-15 years$100 - $200Elevated outdoor livingGround-level, termite areas
Composite deck$2,500 - $4,50025-30 years$20 - $40Premium outdoor livingTight budgets, DIY projects
Asphalt pad$400 - $80015-20 years$50 - $100Temporary parking, cold climatesHot climates, permanent structures

Bottom line: For a permanent, low-maintenance 10x10 surface, concrete is the most cost-effective choice over its lifespan. Gravel is cheaper upfront but requires constant maintenance and does not provide a solid foundation. Pavers look great but cost more upfront and settle over time. Wood decks cost 2-3x more and need regular staining. Asphalt softens in heat and has a shorter lifespan.

Frequently Asked Questions

How much does a 10x10 concrete slab cost?

A 10x10 concrete slab costs $600 to $1,200 for a standard 4-inch residential pour with broom finish and wire mesh reinforcement in 2026. Add decorative finishes, thicker pours, or rebar reinforcement and the range extends to $1,500-$2,500. DIY material costs run $540-$620.

How many bags of concrete for a 10x10 slab?

A 10x10 slab at 4 inches thick requires 56 bags of 80-pound concrete mix or 74 bags of 60-pound mix. Each 80-pound bag yields approximately 0.60 cubic feet. For 1.23 cubic yards (33.2 cubic feet), you need 56 bags. Always buy 10% extra (62 bags of 80lb) to account for waste, spills, and uneven ground.

How thick should a 10x10 patio slab be?

4 inches is the standard thickness for a 10x10 patio slab. This is sufficient for foot traffic, patio furniture, and light use. If you are parking a vehicle, installing a hot tub, or building a foundation, upgrade to 6 inches with rebar reinforcement. A 3-inch slab is not recommended for any permanent installation.

How much does a 10x10 concrete slab weigh?

A 10x10 slab at 4 inches thick weighs approximately 4,950 pounds (about 2.5 tons). At 6 inches, it weighs approximately 7,425 pounds. Concrete weighs 150 pounds per cubic foot. A 10x10x4" slab is 33.2 cubic feet x 150 lbs = 4,980 lbs.

Do I need rebar for a 10x10 slab?

For a basic patio or shed pad, wire mesh is sufficient. Use rebar (#3 at 18" grid) if you are parking vehicles, installing heavy equipment, or building a foundation that requires anchor bolts. Rebar adds $140-$185 to a 10x10 slab but provides significantly more strength. Fiber mesh ($15-$25) is a good supplemental add-on but should not replace physical reinforcement on load-bearing slabs.

How long does a 10x10 slab take to pour?

A 10x10 slab takes 2-4 hours to pour and finish with a small crew (2-3 people). The concrete truck unloads in 30-45 minutes, and finishing (screeding, floating, edging, control joints) takes 1-2 hours. Curing begins immediately and continues for 28 days. The slab is walkable after 24-48 hours and ready for light use after 7 days.

Can I pour a 10x10 slab myself?

Yes, a 10x10 slab is small enough for a DIY project if you have experience with concrete work. You will need 56 bags of 80-pound concrete (or 1.23 cubic yards ready-mix), wire mesh, forms, and basic finishing tools. The challenge is mixing, pouring, and finishing before the concrete sets — typically 2-4 hours. If you are new to concrete, consider hiring a pro for your first 10x10 slab and learning from the process.

Do I need a permit for a 10x10 concrete slab?

It depends on your municipality. Some require permits for any concrete slab, while others only require them for slabs attached to a structure or over a certain size. Check with your local building department before starting. Permit costs range from $50 to $500. Unpermitted work can cause problems at resale and may violate homeowner insurance policies.

How much does it cost to remove an old 10x10 concrete slab?

Removing an old 10x10 concrete slab costs $200-$600, depending on thickness and accessibility. DIY removal with a sledgehammer and pry bar is possible but labor-intensive (expect 4-8 hours of hard work). Professional removal includes hauling and disposal. Disposal fees add $30-$50 per ton.

What is the cheapest way to pour a 10x10 slab?

The cheapest way is to DIY with ready-mix delivery (not bagged), wire mesh, and a broom finish. Material costs run approximately $540. The trade-off is time, physical labor, and the risk of mistakes. For a guaranteed result with warranty, hire a contractor for $600-$1,000. Never skip reinforcement or proper base preparation to save money — this causes cracking and costs more to repair than the initial savings.

How much does a 10x10 stamped concrete patio cost?

A 10x10 stamped concrete patio costs $1,500-$2,500 in 2026. This includes the base slab ($600-$1,000) plus the stamping labor and materials ($500-$1,200). The pattern complexity affects price — simple ashlar slate costs less than intricate cobblestone or wood plank patterns. Color hardener adds $200-$400 more.

Can you pour concrete over an existing 10x10 slab?

Yes, if the existing slab is in good condition — no major cracks, settling, or crumbling. The old surface must be cleaned, roughened (shot-blasted or scarified), and a bonding agent applied. New concrete should be at least 2 inches thick over the old slab. If the existing slab has structural issues, remove it and pour fresh. Resurfacing an old 10x10 slab costs $300-$800 versus $600-$1,200 for full replacement.

⚠️
Disclaimer: Images in this article are AI-generated and for illustrative purposes only. Prices and cost estimates are based on 2026 national averages and may vary significantly by region, contractor, and project complexity. Always get multiple local quotes before starting a project. Verify permit requirements with your local building department.

Data Sources

Related Calculators & Tools

Related Posts

N
Construction & Cost Analysis

Numvex Editorial Team

Our team combines construction industry research with data analysis. We source pricing from HomeAdvisor, Angi, NRMCA, FRED PPI data, and contractor networks across the US. Every guide is fact-checked against multiple industry sources before publishing.

✓ Last reviewed: August 2026 · Prices updated with 2026 national averages · Next review: November 2026
